We have always greatly appreciated Visual Planning for Projects (VPP) from AXtension as a very useful third-party tool to enhance the standard Dynamics 365 (D365) system. This applies particularly to Engineer-to-Order manufacturing companies (or IEM companies—Industrial Equipment Manufacturing).
VPP is a tool of great interest for Engineer-to-Order companies that do project manufacturing. These companies cannot use MRP as their only planning tool. They need project planning. These companies often use Microsoft Project in addition to an MRP system, and manually keep these two systems in sync. AXtension VPP makes it possible to have one hybrid planning system where project planning and MRP work together in sync. In addition, its fundamental feature is the GANTT chart that shows the project WBS.
A few of the well known strong points of VPP:
In this article we will only focus on the graphical planning capabilities of VPP. The latest release of VPP—Version 9.3—prompted me to dedicate a blog article to it, because important features have been added.

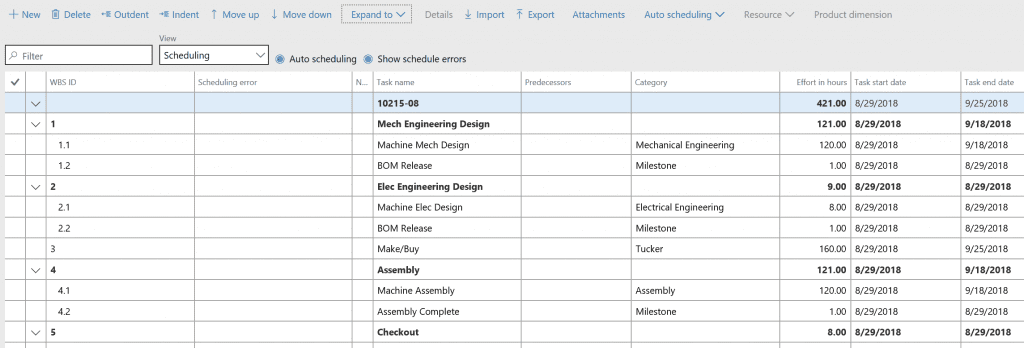

This is the renewed Task planning screen or the GANTT chart that is a direct representation of a standard D365 as shown below.
One of the important features of VPP was always the fact you can link your WBS tasks in three ways. You can do Start-Start, Finish-Finish in addition to the Finish-Start link (standard system only has Finish-Start). You can also add a time buffer between tasks. With the new release, you can do this linking graphically, which is a lot faster.
How to create links between tasks in the GANTT chart
I highlight two (or more) tasks and chose “Arrange options/Link.” Use the CTRL key to highlight multiple tasks. Or “cast a net” around a bunch of tasks to highlight them as a group.
I am choosing one of the three link types and “hard/soft.”
Let’s try “soft” first, see below.
The top two tasks have a hard connection, they are FS scheduled.
The middle ones have a soft connection. We see a dotted line. They are logically connected but apparently we have no need to really schedule them Finish-Start (yet).
How to add overlap between tasks
Overlap can only be added the traditional way in “edit task.” Make sure the GANTT chart is in Edit mode, then click “Edit task.”
In the bottom of the “Details” screen, we find “Links.”
If you scroll to the right, there is a “delay” field.
The delay can be defined in other units then days.

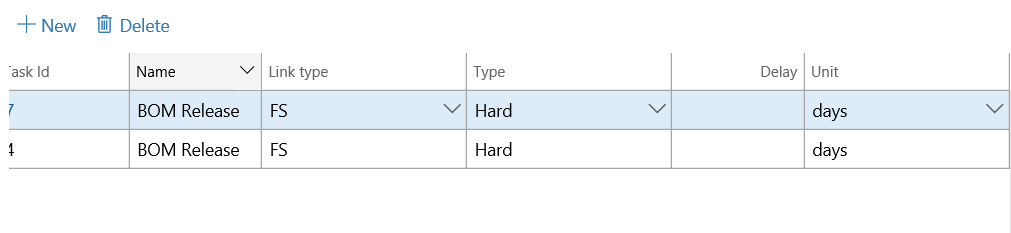

Finish-Start: BOM release follows Machine Elec design without delay.
Finish-Start with 2 days of delay.
Two tasks with a Start-Start relationship and a delay.
It happens that a group of tasks has to be rescheduled. In the standard system WBS, there is no way to backward schedule from a milestone. It is a very normal requirement. With AXTENSION VPP I can schedule backward (and forward) easily but the power is in the detail, as always. Pay close attention to what follows!
Highlight all tasks to be scheduled together by drawing a net around them. Now an entire set of WBS tasks is highlighted.
Here is the secret to reschedule them:
Always use a “push” when dragging all tasks to a new date. What does this mean? It is quite logical.
If my set of tasks should be rescheduled to an earlier date, meaning they move to the left in the GANTT chart, I push the task positioned at the far right to the left, which will push all connected and highlighted tasks to the left also. I am backward rescheduling a group of tasks to an earlier date.
If my group of tasks should be rescheduled to a later date, which means moving to the right in my GANTT chart, I push the task to the far left to the right, which will “push” all connected highlighted tasks to the right. I am now forward scheduling to a later date.
This is easiest done with the “move” function.
You can forward and backward schedule the entire project.
When graphically rescheduling tasks, the system retains all links, including delays, but sometimes it is necessary to “remind” the system as tasks are not lined up correctly after a re-schedule.
That is what the “reapply links” menu is for. Make sure the tasks are highlighted before you “reapply links.”
A new feature in this release that is quite important is the following: in standard D365 for FO, the use of WBS templates is very common. I can build my WBS for a new project very quickly by importing an existing template. Using the standard system, I can only use FS links between my tasks. With VPP, I can use the three types of links, including delay, as explained earlier. While creating my WBS template I will now go to VPP and establish any links and delays that I need, save it and return to standard D365.
Then I export my WBS template. This template now contains the VPP links. Naturally I will forgo the use of the “predecessors” in the standard WBS.
Sikich has recommended AXtension’s VPP for Engineer-to-Order companies for many years. The Version 9.3 release confirms and enhances the value of this software to provide these companies with graphic planning capabilities and a hybrid planning option that is a key feature for these companies. Want to discuss if AXtension Visual Planning for Projects is the right fit for you? Let’s talk.
